PMP Cheat Sheet 2027: Free Quick-Reference Guide for the New Exam

Written byShashank Shastri
Published
Read time19 minread
Hands writing revision notes in a grid notebook beside a laptop, with charts on the papers alongside
Share

This free PMP cheat sheet is rebuilt for the exam you will sit in 2027. It covers the new Exam Content Outline that went live in July 2026, the PMBOK Guide, Eighth Edition, every formula worth remembering, agile and hybrid essentials, and three simple techniques for picking the right answer faster.

If you studied from a 2025 guide, a lot of what you learned still holds. Earned value has not changed, and neither has the critical path. But the exam around those topics has changed more in the last twelve months than in the previous five years.

PMI released the PMBOK Guide, Eighth Edition in November 2025 and switched the PMP exam to a new content outline on July 9, 2026. Business Environment went from 8% of the paper to 26%. Case-based question sets arrived. AI and sustainability now show up inside scenarios.

So we rewrote this cheat sheet from scratch. Use it as a revision layer on top of your main prep, not as a replacement for it.

Who this is for

Anyone sitting the PMP exam from now through 2027, whether you are starting fresh or moving over from older PMBOK 6 or PMBOK 7 material.

Is the credential still worth the effort? PMI's latest Earning Power salary survey (14th edition, 14,628 respondents across 21 countries) found that PMP holders report 17% higher median salaries than non-certified peers. In the United States the gap is closer to 24%.

Section 01

The PMP exam in 2027 at a glance

Start here. If you remember nothing else from this page, remember this table.

ItemWhat to expect
Questions180 in total: 170 scored and 10 unscored pretest questions
Duration240 minutes, up from 230 on the previous exam
BreaksTwo optional 10-minute breaks. The exam clock pauses during them
DomainsPeople 33%, Process 41%, Business Environment 26%
Delivery approachAbout 40% predictive, about 60% agile and hybrid
Question typesMultiple choice, multiple response, drag-and-drop matching, point-and-click, pull-down lists, graphic-based questions and case-based sets
DeliveryPearson VUE test center or online proctored
Languages15
AttemptsUp to three within your one-year eligibility period
Negative markingNone. Answer every question
Pass markNot published. Your report shows a rating for each domain: Above Target, Target, Below Target or Needs Improvement
Renewal60 PDUs every three years

Exam fees differ for PMI members and non-members and vary by region, so check the official PMP page for current pricing before you budget. In most cases, the member discount is larger than the cost of membership.

Are you eligible?

Your educationProject experience neededTraining
High school diploma or equivalent5 years35 hours, or an active CAPM
Associate's degree4 years35 hours, or an active CAPM
Bachelor's degree or higher3 years35 hours, or an active CAPM
Degree from a PMI GAC-accredited program2 years35 hours, or an active CAPM

Experience must fall within the last 10 years. A structured course such as Techademy's PMP certification training covers the 35 contact hours.

Section 02

What changed in the PMP exam, and why it matters for 2027

The new exam is not harder in the sense of being more obscure. It is broader, and it asks you to think like someone who is accountable for outcomes and not just for a plan.

PMI describes the update on its new PMP exam page this way:

Shifts focus to outcomes, value and business impact.

PMIon the new PMP exam

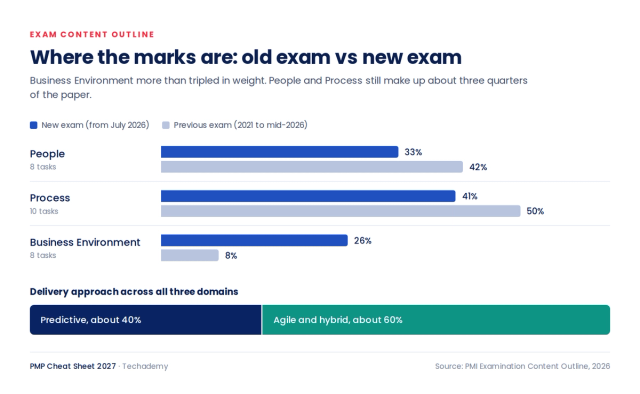

Bar chart comparing PMP exam domain weights. People moved from 42% to 33%, Process from 50% to 41%, and Business Environment from 8% to 26%. About 40% of questions are predictive and 60% agile or hybrid.
ChartDomain weights on the previous exam and on the exam that launched in July 2026.

Here is the side-by-side view.

AreaPrevious exam (2021 to mid-2026)Current exam (July 2026 onward)
People42%33%
Process50%41%
Business Environment8%26%
Tasks in the outline3526
Predictive vs agile and hybridAbout 50/50About 40/60
Time allowed230 minutes240 minutes
Question formatsMultiple choice, multiple response, matching, hotspot, fill-in-the-blankThe earlier formats, plus case-based sets, graphic-based questions, pull-down lists and enhanced matching
Themes tested explicitlyLittle on AI or sustainabilityAI in project work, sustainability, value and benefits, organizational change
Main referencesPMBOK 6, PMBOK 7 and the Agile Practice GuidePMBOK 8 and the Agile Practice Guide

What this means for your prep:

  1. Business Environment deserves real study time. It is now worth roughly one question in four. Governance, compliance, change, risk and continuous improvement all sit here.
  2. Agile and hybrid are the majority. If a concept exists in both worlds, learn both versions.
  3. Expect to read more. Case-based sets give you one long scenario followed by several questions. Reading stamina matters.
  4. Memorizing ITTOs is a poor use of time. Know what each key document is for and when you would reach for it.
  5. Formulas still count, but interpretation counts more. You are more likely to be asked what a CPI of 0.83 means than to compute one from scratch.
Exam tip

The PMBOK Guide is a reference for the exam. The Exam Content Outline is the syllabus. When the two seem to pull in different directions, study to the outline.

Section 03

The 2026 Exam Content Outline: all 26 tasks

PMI's Examination Content Outline lists the tasks every question maps to. Print this table and tick off each task as your confidence grows.

People (33%)Process (41%)Business Environment (26%)
1. Develop a common vision1. Develop an integrated project management plan and plan delivery1. Define and establish project governance
2. Manage conflicts2. Develop and manage project scope2. Plan and manage project compliance
3. Lead the project team3. Help ensure value-based delivery3. Manage and control changes
4. Engage stakeholders4. Plan and manage resources4. Remove impediments and manage issues
5. Align stakeholder expectations5. Plan and manage procurement5. Plan and manage risk
6. Manage stakeholder expectations6. Plan and manage finance6. Continuous improvement
7. Help ensure knowledge transfer7. Plan and optimize quality of products and deliverables7. Support organizational change
8. Plan and manage communication8. Plan and manage schedule8. Evaluate external business environment changes
9. Evaluate project status
10. Manage project closure

Notice where some familiar topics moved. Risk and change control now sit under Business Environment, which is a big part of why that domain grew.

Section 04

PMBOK Guide, Eighth Edition: the cheat sheet

The Seventh Edition (2021) swapped processes for principles, and many candidates found it too abstract to study from. The Eighth Edition brings the two together: principles to guide your judgment, and processes to guide the work.

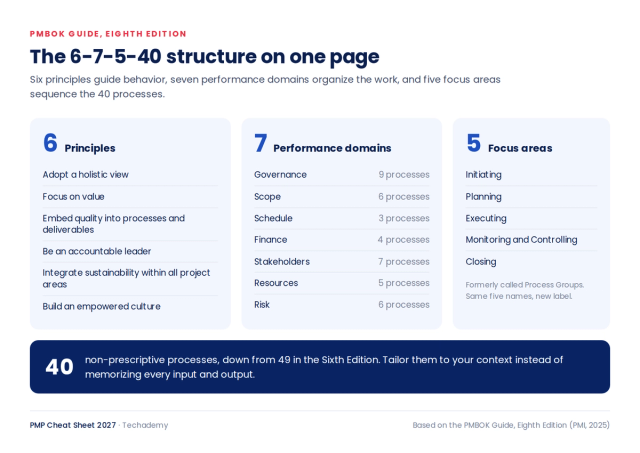

Diagram of the PMBOK 8 structure: 6 principles, 7 performance domains with process counts, 5 focus areas and 40 processes.
DiagramThe Eighth Edition in four numbers: 6, 7, 5 and 40.

PMBOK 6 vs PMBOK 7 vs PMBOK 8

Sixth Edition (2017)Seventh Edition (2021)Eighth Edition (2025)
Organized around10 knowledge areas8 performance domains7 performance domains
PrinciplesNone stated126
Processes49None40
Process grouping5 process groupsNot used5 focus areas
Inputs and outputsFull ITTO tablesMoved to a separate guideBack in the guide, inside each domain
TailoringBrief mentionA principle and a chapterA dedicated section
AINot coveredNot coveredDedicated appendix
SustainabilityNot coveredTouched onA core principle

The 6 principles

PrincipleWhat it means when you are answering a question
Adopt a holistic viewLook at the whole system. A fix that helps one team and hurts the wider organization is rarely the best answer
Focus on valueOutcomes beat outputs. Delivering on time is not success if the benefit never arrives
Embed quality into processes and deliverablesBuild quality in. Prevention is cheaper than inspection
Be an accountable leaderOwn the outcome, act with integrity, and do not pass problems along
Integrate sustainability within all project areasWeigh environmental, social and economic impact alongside cost and schedule
Build an empowered cultureTrust the team, create psychological safety, and push decisions to the people closest to the work

The 7 performance domains and where the old knowledge areas went

Performance domainProcessesAbsorbs these older knowledge areas
Governance9Integration, plus quality assurance and sourcing strategy
Scope6Scope
Schedule3Schedule
Finance4Cost
Stakeholders7Stakeholder and Communications
Resources5Resource
Risk6Risk

Procurement no longer has a domain of its own. Strategic sourcing decisions sit in Governance, and detailed procurement guidance moved to an appendix. It is still in the exam outline (Process, task 5), so do not skip contract types.

All 40 processes on one screen

DomainProcesses
Governance (9)Initiate Project or Phase · Integrate and Align Project Plans · Manage Project Execution · Manage Project Knowledge · Manage Quality Assurance · Plan Sourcing Strategy · Monitor and Control Project Performance · Assess and Implement Changes · Close Project or Phase
Scope (6)Plan Scope Management · Elicit and Analyze Requirements · Define Scope · Develop Scope Structure · Validate Scope · Monitor and Control Scope
Schedule (3)Plan Schedule Management · Develop Schedule · Monitor and Control Schedule
Finance (4)Plan Financial Management · Estimate Costs · Develop Budget · Monitor and Control Finances
Stakeholders (7)Identify Stakeholders · Plan Stakeholder Engagement · Manage Stakeholder Engagement · Monitor Stakeholder Engagement · Plan Communications Management · Manage Communications · Monitor Communications
Resources (5)Plan Resource Management · Estimate Resources · Acquire Resources · Lead the Team · Monitor and Control Resourcing
Risk (6)Plan Risk Management · Identify Risks · Perform Risk Analysis · Plan Risk Responses · Implement Risk Responses · Monitor Risks

The five focus areas are the old process groups under a new name: Initiating, Planning, Executing, Monitoring and Controlling, and Closing. They are not phases. They repeat inside every phase and every iteration.

Remember

The 40 processes are described as non-prescriptive. You are expected to tailor them to the project. If an answer option says "follow every process exactly as documented," be suspicious.

Section 05

Essential PMP formulas

You do not get a formula sheet in the exam. The good news is that the list is short, and most of it is subtraction and division.

Earned value management (EVM)

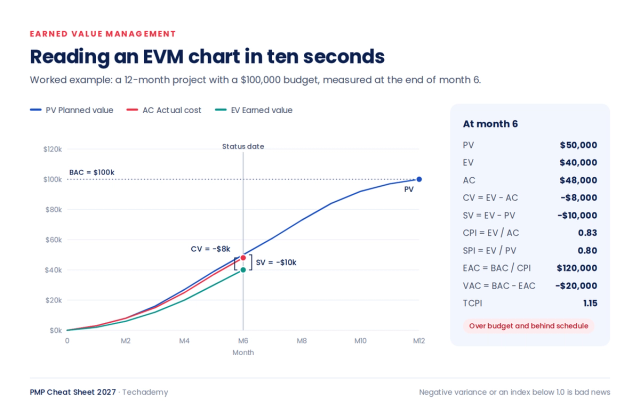

Earned value chart for a 12-month, $100,000 project at month 6. Planned value is $50,000, earned value $40,000 and actual cost $48,000, giving a cost variance of minus $8,000 and a schedule variance of minus $10,000.
ChartA worked EVM example. Earned value sits below both planned value and actual cost, so the project is behind schedule and over budget.
TermFormulaHow to read it
Planned value (PV)BAC × planned % completeWork you should have done by now
Earned value (EV)BAC × actual % completeWork you have actually done, at budgeted rates
Actual cost (AC)Sum of costs to dateWhat you have spent
Cost variance (CV)EV - ACNegative means over budget
Schedule variance (SV)EV - PVNegative means behind schedule
Cost performance index (CPI)EV ÷ ACBelow 1.0 means over budget
Schedule performance index (SPI)EV ÷ PVBelow 1.0 means behind schedule
Estimate at completion (EAC), typicalBAC ÷ CPICurrent cost performance will continue
EAC, atypicalAC + (BAC - EV)The variance was a one-off
EAC, cost and schedule both matterAC + [(BAC - EV) ÷ (CPI × SPI)]Both indices will affect remaining work
EAC, new estimateAC + bottom-up ETCThe original estimate was flawed
Estimate to complete (ETC)EAC - ACWhat you still need to spend
Variance at completion (VAC)BAC - EACNegative means you will finish over budget
To-complete performance index (TCPI), to hit BAC(BAC - EV) ÷ (BAC - AC)Above 1.0 means you must work more efficiently than planned
TCPI, to hit EAC(BAC - EV) ÷ (EAC - AC)Use when a new EAC has been approved

A memory trick that never fails: EV always comes first. Variances are EV minus something. Indices are EV divided by something. Cost formulas use AC, schedule formulas use PV.

Worked example. BAC is $100,000. At month 6 you planned to be 50% done, you are 40% done, and you have spent $48,000.

text
PV   = 100,000 × 0.50            = 50,000EV   = 100,000 × 0.40            = 40,000CV   = 40,000 - 48,000           = -8,000   (over budget)SV   = 40,000 - 50,000           = -10,000  (behind schedule)CPI  = 40,000 ÷ 48,000           = 0.833SPI  = 40,000 ÷ 50,000           = 0.80EAC  = 100,000 ÷ 0.833           = 120,000 (rounded)ETC  = 120,000 - 48,000          = 72,000VAC  = 100,000 - 120,000         = -20,000TCPI = (100,000 - 40,000) ÷ (100,000 - 48,000) = 1.15

Estimating

FormulaExpressionNotes
Three-point, beta (PERT)(O + 4M + P) ÷ 6Weighted toward the most likely value. The default unless the question says otherwise
Three-point, triangular(O + M + P) ÷ 3Simple average
Standard deviation (σ)(P - O) ÷ 6Measures the spread of one activity's estimate
Varianceσ²Add variances along a path, then take the square root for the path's σ
Confidence ranges±1σ = 68.3%, ±2σ = 95.5%, ±3σ = 99.7%Six sigma equals 3.4 defects per million opportunities

O is optimistic, M is most likely and P is pessimistic.

Schedule and critical path

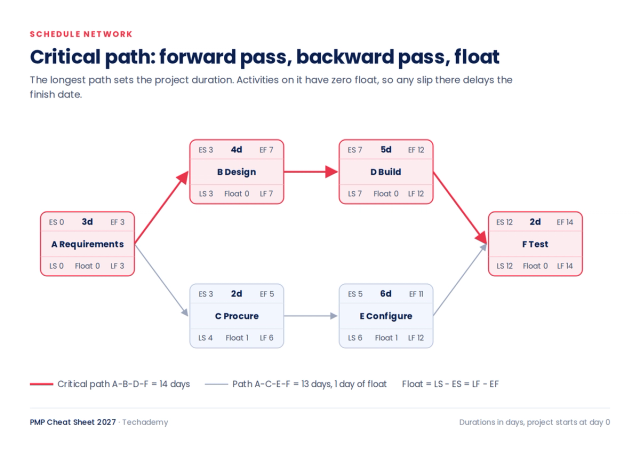

Network diagram with six activities showing early start, early finish, late start, late finish and float. The critical path A-B-D-F takes 14 days and path A-C-E-F has 1 day of float.
DiagramForward pass for early dates, backward pass for late dates, and float is the difference.
FormulaExpression
Early finish (forward pass)EF = ES + duration
Late start (backward pass)LS = LF - duration
Total floatLS - ES, or LF - EF
Free floatES of the next activity - EF of this activity
Project durationLength of the longest path through the network

Three things the exam likes to test:

  • The critical path is the longest path and has zero total float. A project can have more than one.
  • Crashing adds resources and therefore cost. Fast-tracking overlaps activities and therefore adds risk.
  • Resource leveling can change the critical path. Resource smoothing uses only available float, so it cannot.

Communication, risk and procurement

FormulaExpressionExample
Communication channelsn(n - 1) ÷ 210 people = 45 channels. Remember to count yourself
Expected monetary value (EMV)Probability × impact30% chance of a $20,000 loss = -$6,000
Contingency reserveSum of EMVs for identified risksPart of the cost baseline
BudgetCost baseline + management reserveManagement reserve covers unknown unknowns
Point of total assumption (PTA)[(Ceiling price - target price) ÷ buyer's share] + target costFixed-price incentive contracts only

Project selection

MeasureFormulaDecision rule
Present valueFV ÷ (1 + r)ⁿMoney today is worth more than money later
Net present value (NPV)PV of benefits - PV of costsHigher is better. Timing is already built in
Internal rate of return (IRR)The rate at which NPV equals zeroHigher is better
Benefit-cost ratio (BCR)Benefits ÷ costsAbove 1.0 is good
Return on investment (ROI)(Benefit - cost) ÷ costHigher is better
Payback periodInvestment ÷ periodic cash inflowShorter is better
Opportunity costValue of the option you did not chooseNot the difference between the two

Agile metrics

MetricWhat it tells you
VelocityStory points completed per iteration. Use it to forecast, never to compare teams
Iterations remainingRemaining story points ÷ average velocity
Lead timeRequest to delivery, as the customer sees it
Cycle timeWork started to work finished, as the team sees it
ThroughputItems finished per unit of time
Average cycle timeWIP ÷ throughput (Little's Law)
Burndown and burnupWork remaining, or work completed, over time
Exam tip

As soon as the exam starts, you may use the on-screen notes or the erasable note board provided. Write the EVM formulas down once, in the first two minutes, and then stop carrying them in your head.

Section 06

Process domain quick reference

The Process domain is still the largest at 41%. These are the ideas that come up again and again.

Which document answers which question?

If the scenario is aboutLook in the
Why the project exists and who authorized itProject charter
Whether the benefits are being realizedBusiness case and benefits management plan
How the project will be runProject management plan
What is in and out of scopeScope statement, WBS and WBS dictionary
Which requirement links to which deliverableRequirements traceability matrix
A risk that might happenRisk register
A problem that has happenedIssue log
Who is affected and how engaged they areStakeholder register and engagement assessment matrix
A requested change and its statusChange log
What we learned, captured throughout the projectLessons learned register
How the team agreed to work togetherTeam charter
Things believed true but not provenAssumption log

Change control in a predictive project

Memorize this sequence. It is one of the most heavily tested flows on the exam.

  1. Receive the change and record it in the change log.
  2. Assess the impact on scope, schedule, cost, quality, resources and risk.
  3. Identify options and discuss them with the requester.
  4. Submit a formal change request to the change control board (CCB).
  5. If it is approved, update the baselines and the project management plan.
  6. Communicate the decision to the affected stakeholders.
  7. Implement the change and verify the result.

On an agile project the path is shorter: the request goes to the product owner, who adds it to the backlog and reprioritizes. The current sprint stays protected.

Quality

ConceptWhat to remember
Quality vs gradeLow quality is always a problem. Low grade may be perfectly acceptable
Precision vs accuracyPrecision is consistency. Accuracy is closeness to the true value
Prevention vs inspectionPrevention keeps errors out of the process. Inspection keeps them away from the customer
Cost of conformancePrevention costs (training, documentation) and appraisal costs (testing, audits)
Cost of nonconformanceInternal failure (rework, scrap) and external failure (warranty, lost business)
Control chartOut of control if a point falls outside the control limits, or seven consecutive points sit on one side of the mean
Seven basic quality toolsCause-and-effect diagram, flowchart, check sheet, Pareto chart, histogram, control chart, scatter diagram
Validate Scope vs Control QualityControl Quality checks correctness and usually happens first. Validate Scope is formal acceptance by the customer

Contract types and who carries the risk

Contract typeHow it worksCost risk sits with
Firm fixed price (FFP)One price for a defined scopeSeller
Fixed price incentive fee (FPIF)Fixed price plus a bonus for beating targets, up to a ceilingMostly seller
Fixed price with economic price adjustment (FP-EPA)Fixed price, adjusted for inflation or commodity changesShared
Time and materials (T&M)Rate per hour or per unit, scope open-endedBuyer, moderately. Cap it with a not-to-exceed value
Cost plus incentive fee (CPIF)Costs reimbursed, plus a fee tied to performanceMostly buyer
Cost plus award fee (CPAF)Costs reimbursed, plus a fee based on the buyer's subjective judgmentBuyer
Cost plus fixed fee (CPFF)Costs reimbursed, plus a fee that does not changeBuyer

On agile contracts, look for master service agreements with lightweight statements of work, fixed-price increments, and early-cancellation options.

Risk

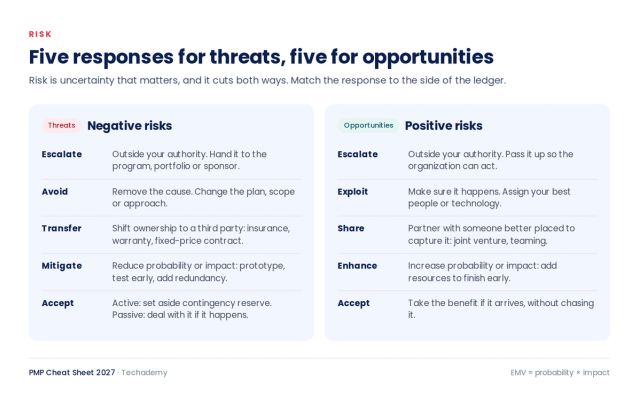

Two-column reference showing five responses for threats (escalate, avoid, transfer, mitigate, accept) and five for opportunities (escalate, exploit, share, enhance, accept).
ReferenceThreats and opportunities each have five response strategies. Escalate and accept appear on both sides.

A few definitions that questions rely on:

  • Risk appetite is how much uncertainty the organization is willing to take on. Risk threshold is the specific level at which it will act.
  • A secondary risk is created by your response. A residual risk is what remains after your response.
  • A contingency plan is prepared in advance. A workaround is an unplanned response to a risk that was not identified or was passively accepted.
  • A trigger is the warning sign that a risk is about to occur.
  • Qualitative analysis ranks risks using probability and impact. Quantitative analysis puts numbers on the overall effect, using tools such as Monte Carlo simulation, decision trees and sensitivity analysis.
Section 07

People domain quick reference

One third of your exam is about leading people. Most of these questions have no formula. They test judgment.

Conflict resolution techniques

TechniqueAlso calledOutcomeWhen it fits
CollaborateProblem-solveWin-winAlmost always the best answer when there is time and trust
CompromiseReconcileBoth sides give something upWhen a temporary or partial solution is acceptable
SmoothAccommodateEmphasizes agreement, plays down differencesTo keep harmony or buy time
ForceDirectWin-loseEmergencies, safety, legal or ethical issues
WithdrawAvoidThe issue is postponedWhen people need to cool down, or the issue is trivial

Conflict is normal and is best resolved early, in private, by the people involved. You step in when they cannot resolve it themselves, and you escalate only when it goes beyond your authority.

Team development

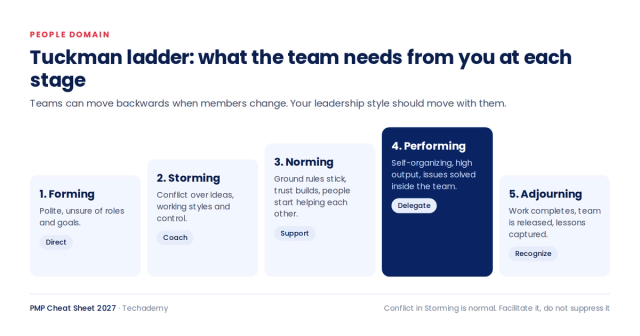

Tuckman ladder showing five stages of team development: forming, storming, norming, performing and adjourning, with the matching leadership style for each: direct, coach, support, delegate and recognize.
DiagramMatch your leadership style to the stage your team is in.

Motivation theories

TheoryCore idea
Maslow's hierarchy of needsLower-level needs such as safety come before higher-level needs such as esteem and self-actualization
Herzberg's two-factor theoryHygiene factors (pay, conditions) prevent dissatisfaction. Motivators (recognition, growth) create satisfaction
McGregor's Theory X and Theory YX assumes people avoid work and need control. Y assumes people are self-motivated
McClelland's theory of needsPeople are driven by achievement, affiliation or power, in different mixes
Vroom's expectancy theoryEffort follows when people believe it leads to performance, and performance leads to a reward they value

Stakeholder engagement

Power and interest grid with four quadrants: keep satisfied, manage closely, monitor and keep informed.
DiagramUse the power/interest grid to decide how much engagement each stakeholder needs.
  • The stakeholder engagement assessment matrix compares each stakeholder's current engagement level with the desired one: unaware, resistant, neutral, supportive or leading.
  • Communication methods come in three kinds: interactive (meetings, calls), push (emails, reports) and pull (portals, wikis).
  • Emotional intelligence has four parts: self-awareness, self-management, social awareness and social skill.
  • Of the types of power available to you, expert and referent power are the most effective. Coercive power is the least.
  • For virtual teams, put extra effort into communication planning, shared working agreements and overlapping hours.
Section 08

Business Environment domain quick reference

This is the domain that grew from 8% to 26%. If your study material predates July 2026, this is where your gaps are most likely to be.

Task areaWhat to know
GovernanceDecision rights, escalation paths, phase gates, steering committees, and the three kinds of PMO: supportive (low control), controlling (moderate) and directive (high)
ComplianceRegulatory, security, safety and data-privacy requirements are non-negotiable. Identify them early, track them, and never trade them away to recover schedule
ChangeIntegrated change control for predictive work, backlog reprioritization for agile work
Impediments and issuesLog the issue, assign an owner, remove the blocker. A servant leader clears the path for the team
RiskThe whole risk life cycle, from planning to monitoring
Continuous improvementRetrospectives, lessons learned throughout the project, Plan-Do-Check-Act, Kaizen, value stream mapping
Organizational changeThe people side of change. ADKAR (awareness, desire, knowledge, ability, reinforcement) and Kotter's eight steps are the models worth recognizing
External environmentScan for political, economic, social, technological, legal and environmental shifts (PESTLE), assess the impact on the backlog or the baseline, then act through the proper channel

Value and benefits

  • Outputs are what the project produces. Outcomes are the change those outputs enable. Benefits are the measurable gains. Value is the net worth of those benefits to the organization.
  • Benefits are often realized after the project closes. The benefits management plan names who owns them and when they will be measured.
  • If the business case stops being valid, the right move is to raise it with the sponsor, even when that might end the project.

AI in project management

The Eighth Edition has an appendix on artificial intelligence, and the new exam places AI inside ordinary scenarios. You will not be asked how a model works. You may be asked how a responsible project manager uses one.

  • Good uses: drafting reports, summarizing meetings, forecasting schedules, spotting risk patterns, optimizing resources.
  • You remain accountable. Verify AI output before acting on it or sharing it.
  • Respect data privacy, confidentiality and your organization's AI policy.
  • Watch for bias, and be transparent with stakeholders about where AI was used.

Sustainability

Think triple bottom line: people, planet and profit. In a scenario, the best answer usually weighs long-term environmental and social impact alongside cost and schedule, and involves the affected stakeholders early.

Section 09

Agile and hybrid essentials

About 60% of the exam sits here. Start by learning to recognize which approach a scenario is describing.

Spectrum from predictive to hybrid to agile, with the characteristics and clue words for each development approach.
DiagramIdentify the approach first. It changes what the right answer looks like.

The Agile Manifesto in four lines

The Agile Manifesto values:

  • Individuals and interactions over processes and tools
  • Working software over comprehensive documentation
  • Customer collaboration over contract negotiation
  • Responding to change over following a plan

The items on the right still have value. The items on the left have more.

Scrum

Scrum framework flow from product backlog through sprint planning, sprint backlog, the sprint with a daily scrum, increment, sprint review and sprint retrospective.
DiagramScrum has three accountabilities, five events and three artifacts, each with its own commitment.

Scrum vs Kanban vs XP

ScrumKanbanExtreme Programming (XP)
CadenceFixed-length sprintsContinuous flowShort iterations
RolesProduct owner, scrum master, developersNone prescribedCoach, customer, programmers
Work is limited bySprint capacityWIP limits per columnIteration capacity
Key metricsVelocity, burndownLead time, cycle time, throughputVelocity, defect rates
Known forEvents and artifactsVisualizing work and pulling it throughPair programming, test-driven development, continuous integration, refactoring
Change arrivesBetween sprintsAt any time, if capacity allowsBetween iterations

More agile terms worth knowing

  • Servant leadership: remove impediments, shield the team from interruptions, coach, and facilitate. Do not assign tasks or make the team's technical decisions.
  • Definition of Done (DoD): the shared quality bar for every increment. Definition of Ready (DoR): what a backlog item needs before the team can pull it in.
  • User story format: As a role, I want capability, so that benefit. Good stories follow INVEST: independent, negotiable, valuable, estimable, small, testable.
  • Estimation: story points, planning poker, T-shirt sizing, affinity estimating. Estimates are relative, not absolute.
  • Prioritization: MoSCoW (must, should, could, won't), the Kano model, and value versus effort.
  • MVP and MBI: the minimum viable product tests a hypothesis. The minimum business increment delivers real value.
  • Information radiators: big, visible charts such as Kanban boards and burndown charts, placed where everyone can see them.
  • Lean: eliminate waste, build quality in, create knowledge, defer commitment, deliver fast, respect people, optimize the whole.
  • Scaling frameworks: SAFe, LeSS, Scrum of Scrums and Disciplined Agile. Recognize the names and what they are for.

Hybrid in practice

  • Use predictive planning for the parts that are stable or regulated, and iterations for the parts that are uncertain.
  • Keep governance consistent, even when the cadence changes from team to team.
  • When a predictive organization is moving to agile, start with a pilot, train the people involved, and bring in a coach.
Remember

Agile is a mindset before it is a method. When two options both sound "agile," choose the one that delivers value earlier and gets feedback sooner.

Section 10

The PMI mindset: how the "right" answer thinks

Most situational questions offer two options that are clearly wrong and two that both sound reasonable. The PMI mindset is how you separate those last two.

A PMP usually does thisA PMP almost never does this
Assesses the situation before actingActs on assumptions or incomplete information
Talks to the person or team involved firstGoes straight to the sponsor, HR or a functional manager
Follows the agreed process, such as change control or backlog refinementMakes unilateral changes to scope, schedule or budget
Looks for the root causeTreats the symptom and moves on
Collaborates, facilitates and coachesCommands, blames or punishes
Is proactive about risks and stakeholdersWaits for a problem to grow before responding
Is honest about status, even when the news is badHides, delays or softens bad news
Protects value, compliance and ethicsCuts quality, safety or testing to hit a date
Empowers the team to decide how the work is doneMicromanages or assigns tasks on an agile team
Tailors the approach to the contextApplies one method rigidly to everything
Section 11

3 proven techniques for finding the correct answer faster

PMP questions are wordy on purpose. To answer them quickly and with confidence, you need to look past the dense phrasing and pinpoint exactly what PMI is testing. These three techniques help you do that, and they make it much easier to eliminate the distractor options.

Three exam techniques: the Yoda Test to find the true core of the question, the Sherlock Scan to hunt for clues, and the Mario Kart Rule to keep moving.
DiagramSimplify the question, investigate the clues, and keep moving.

The Yoda Test: find the true core of the question

Strip the story. Keep the process.

Scenarios are packed with background noise: stakeholder drama, names, job titles and metrics you will never use. The Yoda Test forces you to strip all of that away and restate the question in its simplest form.

How it works

  1. Read the whole scenario once.
  2. Go to the very last sentence. That is the actual question.
  3. Flip the scenario into one short, Yoda-style premise that names the situation and the PMI process behind it.
What the scenario saysThe Yoda-style core
A senior stakeholder storms into your office, furious, and demands a new feature before launch"A change is requested. Follow the plan, you must."
A supplier you flagged as shaky months ago has just gone bankrupt, and the team is panicking"A risk has happened. The issue log, update you will."
Two developers argue loudly about a design decision during the sprint"A conflict, the team has. Facilitate, you must. Decide for them, you must not."
The sponsor asks you to skip user testing so that the launch date holds"Cut quality, you must not. Show the impact, you will."

Why it works: It stops you from getting emotionally invested in the story, whether that is an angry stakeholder or a team member in tears. Your attention goes to the underlying process, which is the only thing being marked.

The Sherlock Scan: hunt for the critical clues

Audit the text before you look at the answers.

PMI plants specific trigger words in every scenario, and the right clue can eliminate two or three options on its own. The Sherlock Scan means checking the text for those clues before you read the options.

Timeline clues tell you where you are in the project.

Clue in the scenarioWhere you areWhat it tells you
"The charter was just approved"Start of planningNo baselines exist yet, so an option involving a change request is almost certainly wrong. Identify stakeholders and begin planning
"While developing the plan"PlanningThe plan is still a draft, so you update it directly. Formal change control begins once baselines are approved
"During execution," "the baseline was approved"Executing, or monitoring and controllingAny change to scope, schedule or cost goes through integrated change control
"Deliverables have been accepted"ClosingThink final report, lessons learned, archiving, transition to operations and releasing the team

Approach clues tell you which playbook applies.

If you seeThe project isLook for answers that
Sprint, backlog, product owner, servant leader, retrospectiveAgileCollaborate, facilitate, coach, and let the product owner reprioritize
Variance, baseline, formal approval, phase gate, CCBPredictiveFollow change control, analyze the impact, update the logs and the plan
A mix of bothHybridRespect the governance and keep the iterative cadence

Two more clues are worth a quick look:

  • The qualifier. FIRST, NEXT, BEST, MOST LIKELY, NOT and EXCEPT each change which option is correct.
  • What has already happened. If the scenario says the impact has been analyzed, "analyze the impact" is no longer the answer.

The Mario Kart Rule: keep moving forward

Never lose your momentum on a single question.

Hesitation is your biggest enemy on this exam. In a kart race, clipping an obstacle costs you a second. Stopping to stare at it costs you the race. When you hit an obstacle in the exam, use a power-up (eliminate the obviously bad answers) and keep driving.

  • The 30-second rule. If you have read the question and cannot see a path to the answer within 30 seconds, do not sit and stare at it.
  • Eliminate and flag. Cross out the two options that are clearly wrong. They are usually the ones that involve firing someone, complaining to the sponsor, or taking immediate action without any analysis. Choose the best remaining option, flag the question, and move on.
  • Hold your pace. You have 80 seconds per question on average. Treat two minutes as the absolute ceiling.
  • Review inside the section. Flagged questions can only be revisited before you submit that section, so leave a few minutes for them before each break.

Why it works: Staying on pace gives you a psychological boost. And quite often, a later question jogs the memory or the logic you needed for one you flagged earlier.

See all three techniques in action

Sample question. Priya, a senior developer on your hybrid project, has missed her commitments in two sprints running. At the coffee machine, a visibly frustrated teammate tells you she is "not pulling her weight" and that the whole team is fed up. What should you do FIRST?

  • A. Report the developer's performance to her functional manager
  • B. Meet the developer privately to understand what is getting in the way
  • C. Reassign the developer's backlog items to stronger team members
  • D. Ask the team to confront the issue in the next retrospective

Yoda Test: Drop the coffee machine, the frustration and the name. What is left is this: "A performance problem, there may be. The cause, you know not. Understand first, you must."

Sherlock Scan: The qualifier is FIRST. The word "sprints" points to an agile way of working, so look for coaching and direct conversation. Nothing has been investigated yet, because all you have is a secondhand complaint. That rules out A (escalating without facts) and C (acting on an assumption), and D turns a personal matter into a public one.

Mario Kart Rule: That took well under a minute. Select B, skip the flag, and drive on.

Section 12

Strategies for each question type

Question typeWhat it looks likeHow to handle it
Situational multiple choiceA short scenario with four optionsYoda Test, then the Sherlock Scan. This is the bulk of the exam
Multiple response"Choose two" or "choose three"Treat every option as true or false on its own, then select exactly the number asked for
Drag-and-drop matchingMatch terms to definitions, or steps to a sequencePlace the ones you are sure of first. The rest often resolve by elimination
Point-and-clickClick the right area on a chart or diagramRead the axes and the legend before you read the question again
Pull-down listComplete a statement by choosing from a listRead the finished sentence back to yourself. It should make sense as a whole
Graphic-basedInterpret a burndown chart, control chart, Kanban board or EVM graphAsk what the trend is and what a project manager should do about it
Case-based setOne longer scenario followed by several questionsRead the case carefully once and note the approach, the stakeholders and the constraints. Then answer each question on its own merits
CalculationEVM, PERT, float or communication channelsWrite the formula, plug in the values, check the units, and sanity-check the sign

Two more practice questions

Business Environment. Midway through a predictive project, the government announces a data-privacy regulation that will take effect before your go-live date. What should the project manager do NEXT?

  • A. Continue as planned and deal with compliance after go-live
  • B. Assess the regulation's impact on the project and submit a change request
  • C. Instruct the team to redesign the affected modules immediately
  • D. Add the regulation to the risk register and monitor it

Answer: B. Compliance is not optional, so A is out. C skips impact analysis and change control. D treats something certain as if it were a risk. It is a confirmed external change, so assess it and take it through integrated change control.

Process. Your status report shows a CPI of 1.10 and an SPI of 0.85. Which statement is accurate?

  • A. The project is over budget and ahead of schedule
  • B. The project is under budget and behind schedule
  • C. The project is over budget and behind schedule
  • D. The project is under budget and ahead of schedule

Answer: B. An index above 1.0 is good and below 1.0 is bad. Cost is healthy and schedule is not. A sensible next step would be to see whether the cost headroom can be used to recover time on the critical path.

Section 13

Time management during the exam

You have 240 minutes for 180 questions, which works out to 80 seconds each.

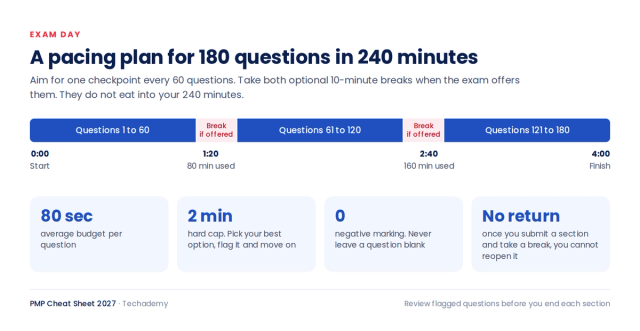

Pacing plan for the PMP exam: reach question 60 by 80 minutes and question 120 by 160 minutes, with an average budget of 80 seconds per question and a two-minute cap.
DiagramCheckpoints keep you honest. If you are behind at a checkpoint, shorten your reading, not your thinking.
  • Set checkpoints. Aim for question 60 by the 80-minute mark and question 120 by the 160-minute mark.
  • Take both breaks. They do not come out of your 240 minutes, and your accuracy in the final hour depends on them.
  • Review before you break. Once you submit a section and start a break, you cannot go back to those questions.
  • Use the 30-second rule. If no path to the answer appears within 30 seconds, eliminate, choose, flag and move on.
  • Limit your flags. If you flag more than ten or so questions per section, you will not have time to review them properly.
  • Trust your first answer. Change it only when you spot a clue you missed, not because of a vague feeling.
Section 14

An 8-week study plan

Eight weeks at 10 to 12 hours a week is enough for most working professionals. Stretch it to 12 weeks if your schedule is tight, or compress it to 4 if you can study full-time.

WeekFocusTarget by the end of the week
1Exam Content Outline, PMI mindset, PMBOK 8 principles and structureYou can explain 6-7-5-40 without notes
2Process: governance, scope, scheduleCritical path and float solved by hand
3Process: finance, quality, resources, procurementEvery EVM formula written from memory
4People: leadership, conflict, teams, stakeholders, communication50 situational questions at 65% or better
5Agile and hybrid: Scrum, Kanban, XP, Lean, servant leadershipAgile Practice Guide read once, end to end
6Business Environment: governance, compliance, change, risk, AI, sustainability50 Business Environment questions at 65% or better
7First full-length mock exam, followed by a line-by-line review70% or better, with your weak tasks identified
8Second and third mock exams, formula drills, a lighter final two days75% or better across two consecutive mocks

Daily habits that make the plan work:

  • Study in focused blocks of 25 to 45 minutes, with short breaks between them.
  • Finish every session with 10 to 20 practice questions on what you just covered.
  • Keep an error log. For every wrong answer, write one sentence on why the correct option was better.
  • Re-read this cheat sheet once a week. It should start to feel familiar by week 4.
  • Teach a concept to a colleague or a study partner. If you cannot explain it simply, revisit it.

Common mistakes to avoid

  1. Studying only from PMBOK 6 or PMBOK 7 material without checking it against the new outline.
  2. Treating Business Environment as an afterthought.
  3. Memorizing ITTOs instead of understanding how documents and processes connect.
  4. Saving mock exams for the final week, which leaves no time to fix what they reveal.
  5. Taking mocks without reviewing the questions you got right for the wrong reasons.
  6. Cramming the night before. Sleep does more for your score than one more chapter.
Section 15

Exam-day checklist

The day before

  • Confirm your appointment time and test center address, or run the system check for online proctoring
  • Check that the name on your government-issued ID matches your PMI registration exactly
  • Skim this cheat sheet and your error log once, then stop studying by early evening
  • Get a full night's sleep

On the day

  • Arrive 30 minutes early, or log in 30 minutes early for the online exam
  • Eat a proper meal and go easy on the caffeine
  • Write down your key formulas as soon as the exam begins
  • Hit your pacing checkpoints at questions 60 and 120
  • Take both breaks
  • Answer every question before you submit
Section 16

Resources worth your time

You do not need ten resources. You need three or four good ones, used properly.

From PMI

Beyond PMI

  • The Scrum Guide: short enough to read in one sitting. Read it twice.
  • r/pmp on Reddit: recent exam experiences and study tips. Filter for posts dated after July 2026.
  • Your local PMI chapter: study groups, mentoring and networking.
  • A flashcard app such as Anki or Quizlet for formulas and definitions.
  • Techademy's PMP certification training: live instructor-led classes, 35 contact hours, mock exams and application support.
Project ManagementTop 50+ PMP Exam Questions and Answers for 2025
Section 17

Your next step

The PMP exam you will sit in 2027 asks for more range than the old one did, and it rewards something you already have: the judgment that comes from running real projects. What this cheat sheet adds is structure, so that your judgment can show up under time pressure.

Here is what to do this week:

  1. Download the Exam Content Outline and rate your confidence on each of the 26 tasks.
  2. Write out the EVM formulas from memory and check them against the table above.
  3. Try the Yoda Test, the Sherlock Scan and the Mario Kart Rule on your next 20 practice questions.
  4. Book your exam date. A deadline does wonders for focus.

If you would like a structured path with live instructors, mock exams and help with your application, explore Techademy's PMP certification training.

Found this useful? Bookmark it, share it with your study group, and come back to it the night before your exam.

PMP, PMBOK, PMI and CAPM are registered marks of the Project Management Institute, Inc.

Author
Shashank Shastri
Coach & Mentor/317 articles

Shashank Shastri is a PMP trainer with over 14 years of experience and co-founder of Oven Story. He is an inspiring product leader who is a master in product strategies and digital innovation. Shashank has guided many aspirants preparing for the PMP examination thereby assisting them to achieve their PMP certification. For leisure, he writes short stories and is currently working on a feature-film script, Migraine.

Questions people ask

Published  /  Last updated

Empowering you to learn and grow 💪

Helping learners build future-ready skills through practical, career-driven education.

Empowering you to learn and grow 💪

Helping learners build future-ready skills through practical, career-driven education.

Connect with us

The core formulas, and the 100 questions that use themThe core formulas, and the 100 questions that use them
The kit recent first-attempt passers keep beside them for the final two weeks of prep.
